Insight

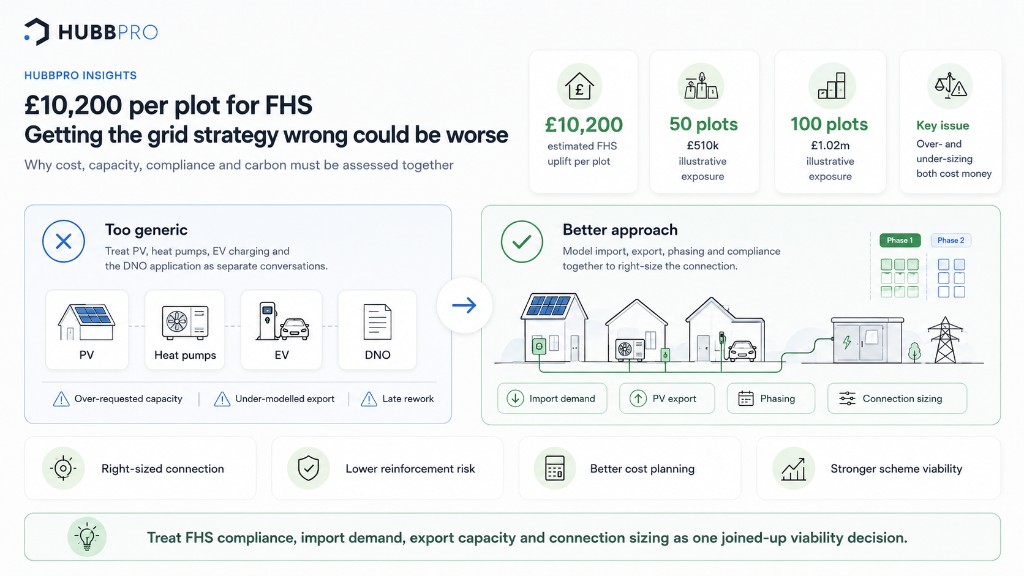

£10,200 per plot for FHS is painful. Getting the grid strategy wrong on top could be worse.

£10,200 estimated FHS uplift per plot. Treating PV, heat pumps, EV charging, and DNO applications separately risks over-requested capacity, under-modelled export, and late rework.

Why is Future Homes Standard a viability issue, not just compliance?

Future Homes Standard is often talked about as a technical or compliance issue. That is understandable. It involves fabric standards, heating systems, PV, energy performance, carbon reduction, SAP or HEM, and a long list of technical choices that design teams must make.

But for housebuilders and developers, the bigger issue is simpler. It is cost. It is viability. It is whether the scheme still stacks up once every extra requirement, assumption, and infrastructure decision has been added into the appraisal.

The Home Builders Federation's recent Viability Crunch report makes that point clearly. It estimates that new taxes, levies, policy costs, and inflationary pressures have the potential to add £76,000 to the cost of building a home compared with five years ago. Within that, Future Homes Standard is identified as adding £10,200 per unit for an average low-rise 90m² house.

That is not a rounding error. On a 50-unit scheme, that is over half a million pounds before you start thinking about additional grid reinforcement, programme delays, design rework, or the cost of assumptions being made too late.

The real risk with FHS is not simply whether a scheme can technically comply. The more important question is whether the route to compliance is commercially sensible for that specific site.

Why is treating connected decisions separately a risk?

Most residential schemes still treat utilities, FHS, and low-carbon technology decisions as separate conversations. PV is looked at through one lens. Heat pumps through another. EV charging through another. The DNO application is often handled later. Cost planning tries to keep up in the background.

This may have worked when the electrical strategy for a housing development was relatively simple. Traditional gas-heated developments had smaller, diversified electrical import loads. The infrastructure approach was more predictable.

That is not the world we are moving into. All-electric homes change the load profile of a development. Heat pumps increase import demand. EV charging adds further import load. PV creates export. Batteries can create both import and export. Time-of-use tariffs can shift behaviour across many homes at the same time.

The Future Homes Hub's guide on grid connections for all-electric houses explains that all-electric new homes add new import and export loads, which create significant demands on substations and cabling infrastructure when aggregated across a development. It also highlights the risk of large local import and export peaks from PV, energy storage, and smart tariffs.

One heat pump is not the issue. One EV charger is not the issue. One PV array is not the issue. The issue is what happens when those assumptions are multiplied across a scheme, phased over time, and submitted into a grid connection process without the right level of analysis.

Why are over-assessing and under-assessing both problems?

A lot of attention is put on not underestimating electrical demand. That is fair. No developer wants to find out too late that the site does not have enough capacity.

But over-assessing can be just as damaging. The Future Homes Hub guide states that most applications currently ask for too much power, too early, and that accurate load assessment and realistic load profile phasing plans are key to securing a connection as quickly and cost-effectively as possible.

If the development asks for too much capacity too soon, it can lead to higher infrastructure costs, unnecessary reinforcement, longer lead times, or a less attractive connection route. If the development asks for too little, the project risks redesign, delay, constraint, or painful changes later.

The objective is not to maximise the application. The objective is to right-size it. That means understanding the realistic import and export position for the development, not just adding up nameplate values or applying blunt assumptions. It also means thinking about phasing. A 100-home scheme does not necessarily need all of its ultimate electrical demand on day one.

Why does FHS make early decisions more valuable?

The HBF report frames FHS as part of a wider viability crunch. It is one cost pressure among many: building regulations, biodiversity net gain, taxes, material inflation, labour inflation, Section 106 inflation, nutrient neutrality, and more.

Developers cannot control every external cost or policy change. But they can control how early they understand the implications of their assumptions.

A scheme starts with a high-level energy strategy. Assumptions flow into planning, cost plans, technical design, and utility applications. By the time someone properly challenges them, they may already be embedded. The site layout may have moved on. The roof strategy may be fixed. The DNO application may have been submitted.

The developer is then left trying to unpick decisions that should have been tested earlier. That is expensive, not always because the technical solution is wrong, but because the timing is wrong.

What practical questions should developers ask earlier?

A better question than “Can we comply with Future Homes Standard?” is: “What is the most commercially sensible route to comply on this specific scheme?”

  • How much PV is actually required?
  • How much roof space is realistically available?
  • What happens if the 40% ground floor area rule does not translate neatly into practical roof layouts?
  • What export position does the PV create?
  • Is export based on realistic modelling, or on total installed PV capacity?
  • What do heat pumps do to import demand?
  • What happens when EV charging is included?
  • Are batteries helping the site or creating new import/export peaks?
  • Does phasing reduce the immediate connection requirement?
  • Could load management, storage, or alternative connection strategies reduce risk?
  • Should an ICP or IDNO route be considered earlier?
  • What does all of this mean for cost, capacity, compliance, and viability?

These are not abstract technical questions. They affect land bids, planning strategy, technical risk, programme, procurement, infrastructure cost, and sales confidence.

Why is grid strategy now part of viability strategy?

Historically, grid connections could sometimes be treated as a later technical package. That is becoming a dangerous habit.

The Future Homes Hub guide is clear that all-electric homes require greater electrical capacity, while other sectors are also competing for capacity. It says this increases the importance of engaging early and making informed connection applications.

Grid strategy needs to sit closer to viability strategy. A small site may only need a quick review to sense-check likely import, export, and connection risk. A larger site may need more detailed scenario comparison. A constrained site may need optioneering around phasing, storage, load management, ICP/IDNO routes, or alternative technical strategies.

The key is proportionality. The level of analysis should match the level of risk. But doing nothing until later is no longer a safe default.

What is HubbPro focused on?

This is the space HubbPro is working in. Not full detailed design. Not generic sustainability advice. Not software for the sake of software.

The focus is early-stage decision support for residential schemes, helping developers, technical teams, and consultants understand how Future Homes Standard, utilities, low-carbon technologies, and grid capacity interact before assumptions become locked in.

That means comparing options through a practical commercial lens: cost, capacity, compliance, and carbon. It means giving developers a clearer view of the implications of different routes, and helping teams avoid two expensive mistakes: over-engineering the solution, or underestimating the risk.

What is the real opportunity?

The Future Homes Standard will add cost. That is now part of the commercial reality. But the bigger opportunity is to stop treating the response to FHS as a disconnected technical exercise.

Developers need clearer, earlier visibility of the decisions that drive cost and infrastructure risk. They need to know whether the PV strategy works, what the export position looks like, how heat pumps and EVs affect import demand, and whether the grid connection route is being right-sized.

Because £10,200 per plot for FHS is painful enough. Getting the grid strategy wrong on top could be worse.

From our work

At HubbPro, we routinely see schemes where PV, heat pumps, EV charging, and DNO applications have been progressed on separate assumptions. By the time import and export are reviewed together, roof layouts, cost plans, or connection applications are already fixed.

In our early-stage reviews for UK residential schemes, the most expensive mistakes are rarely non-compliance. They are timing mistakes: over-requesting capacity, under-modelling export, or locking a layout before the joined-up electrical strategy is tested.

Original examples

Grid connection sizing

Too generic

Apply for maximum capacity upfront so we do not get caught out later.

Better

Phase 1 needs 132 kVA for 40 occupied homes with load-managed EV and staged heat pump commissioning, not the 500 kVA nameplate sum across the full 100-plot masterplan.

Export modelling

Too generic

Total installed PV capacity equals export requirement.

Better

On a 64-home scheme we reviewed, realistic export peaked at 210 kW, not 320 kW from nameplate PV, once occupancy, demand, and roof utilisation were modelled.

Commercial framing

Too generic

Can we comply with Future Homes Standard?

Better

What is the most commercially sensible route to comply on this site, given roof area, phasing, import demand, and connection lead times?

Frequently asked questions

The Home Builders Federation estimates FHS adds around £10,200 per unit for an average low-rise 90m² house, as part of a wider £76,000 increase in build costs compared with five years ago.
